WIND TOWER PRODUCTION LINE

Wind Tower Production Line — Turnkey 6-Stage Tower Manufacturing System

A wind tower production line is the switch that flips whether your shop produces 60 sections per year or 600 – and whether your welds come back as rework or pass third party NDT. Behind that switch, Aubrik builds the integrated, six-stage line: CNC cutting, rolling, fit-up, submerged-arc welding, NDT, and coating, delivered as one machine not one hundred that may or may not communicate well.

We have been building these for projects like onshore wind and offshore wind since 1999 to produce wind turbine tower sections with capacities from 2 MW to 8 MW and diameters up to 8.5 m. For renewable energy as it scales, each wind farm operator and tower fabricator requires a wind tower production line that maintains quality as volume increases. The engineering below reflects the tolerances, standards, and capacities. It avoids adjectives.

SPEC // MATRIX DATA OUTPUT
±1 mm SAW joint accuracy
+40% productivity vs traditional lines
60–600 tower sets / year (modular)
500,000 t steel processed / year
2–8 MW onshore & offshore, ⌀2.5–16 m
EN 1090-2 · DNV EXC3 + DNV-ST-0126 ready

[SYS-DIAGNOSTIC]

The Hidden Cost of a Fragmented, Manual Wind Tower Line

For most wind tower production lines, most capacity problems are fit-up and handling – not welding. At 35 in/min, your robot torch moves much faster than sections can be manipulated, loaded, clamped, and removed by hand; as a result, throughput is determined not by the arc but by manual loading times.

A wind tower is really just stack of tubular cylindrical rolled steel cans – coupled with longitudinal and circumferential welds – then flanged, inspected, and coated.

With manually-fed, separate machinery at each stage of these operations, there are three quiet and mounting cost centers.
[ERR-LOG // BOTTLENECKS]
01

Idle arc time.

Most manual welding work takes only 8-30% of the total machine time, so most of it – while your welders and machinery are on the clock but doing nothing useful – goes to repositioning, cleaning, and waiting.

02

Rework you find late.

One wind industry inspection firm has concluded that nearly two thirds of some 40,000 wind assets from some ten manufacturers exhibited a high risk, with a number found “to have welded over cracks, prioritizing rapid output over correct manufacture” as they rushed to meet demand.

03

The broker trap.

When fabricators outsource welding to sub-contractors because they can’t afford to maintain heavy welding machines in-house, their customers face the risk of long delays when just one of those subs trips up.

ENGINEERING SOLUTION

Integrated welding directly eliminates all three problems at their source because one machine-control logic layer both drives the weld and orchestrates movement between each stage-the engineering solution for the material bottlenecks you can plan against in advance on an Aubrik wind tower production line. Across the country, the U.S. Department of Energy counts over 500 domestic wind manufacturing sites in its wind manufacturing and supply-chain program, where competition among wind tower manufacturers in the wind energy sector turns on exactly this efficiency.

// SYSTEM_OVERVIEW

Inside the Aubrik 6-Stage Wind Tower Production Line

Where thick-plate and offshore segments are a challenge, it’s precisely the problem of fabrication efficiency and deformation control where the heat from massive welds deforms flanges faster than crews can possibly make those repairs. By subdividing the wind tower manufacturing process into six sections of machine and machine feeding closely into the next in line on strict, controlled tolerances – we build in precision and engineer for the control you need to achieve. welding automation follows your schedule, not your mistakes.

Stage-by-stage equipment

01

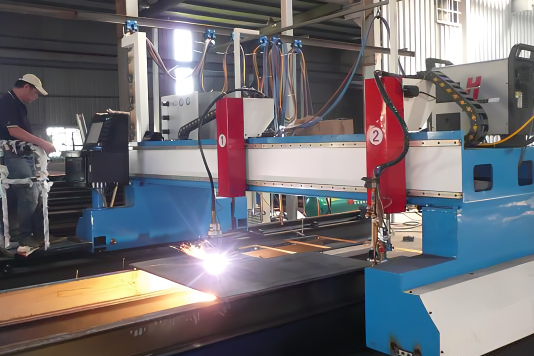

Aubrik CNC plasma cutting and shot blasting raw-material pretreatment

Raw-material pretreatment

CNC plasma cutting with laser positioning and real-time thickness compensation holds 1.5 mm blanking on plate up to 210 mm; shot blasting reaches ISO 8501-1 Sa 2.5 for coating adhesion.

02
Aubrik CNC three-roll bending machine plate rolling forming

Plate rolling & forming

A CNC three-roll bending machine forms cans from 2.5 m to 16 m diameter; a laser section-alignment platform corrects deformation to 0.5 mm on the longitudinal seam.

03

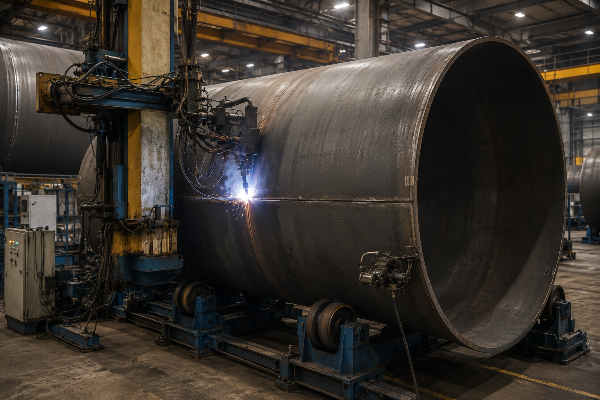

Aubrik Cantilever submerged-arc welding SAW process

Welding

Cantilever submerged-arc welding (SAW) with robotic circumferential tracking holds 1 mm joint accuracy across multiple weld processes (SAW and FCAW). Welding positioners and rotators index each can so the seam stays in the flat position, lifting efficiency over 50% against manual work and producing high-quality, low-porosity welds.

04

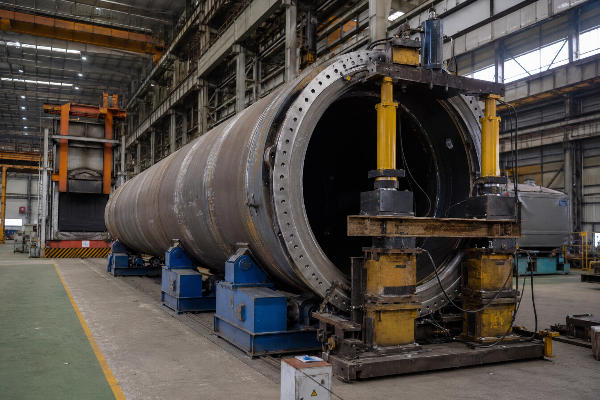

Aubrik Flange assembly and hydraulic straightener

Flange assembly

A 300-ton hydraulic straightener plus post- weld heat treatment holds flange runout below 2 mm/m; CNC flange drilling positions holes to 0.5 mm.

05

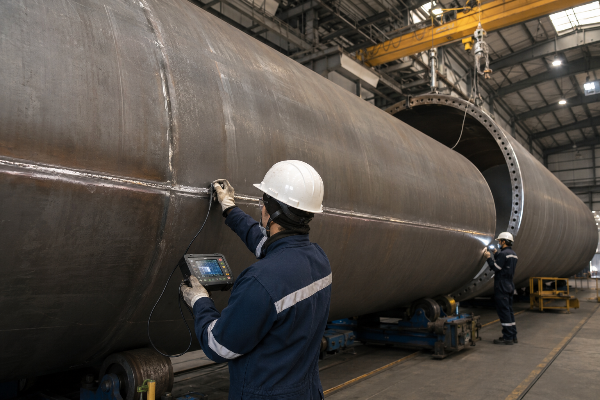

Aubrik Digital ultrasonic testing NDT inspection

NDT & inspection

Digital ultrasonic testing (UT) to NB/T 47013.3 and ISO 17640, with visual inspection to ISO 17637, validates every weld before it moves.

06
Aubrik automatic painting turntable coating and finishing

Coating & finishing

An automatic painting turntable lays 50-200 m film to ISO 12944, with controlled drying for a 25-year service target.

// SPEC_MATRIX

Line Tolerance Stack-Up

Published tolerances only matter if you can see how they accumulate into the finished tower. Here is the accuracy budget the line holds, stage by stage – the number competitors leave blank.

Stage Operation Held tolerance Why it matters downstream
Cutting CNC plasma blanking, ≤210 mm ±1.5 mm Sets can circumference; error here multiplies at roll-up
Forming 3-roll bending, ⌀2.5–16 m uniform curvature Round cans = even root gap for the seam
Fit-up Laser section alignment ±0.5 mm/m Clean joints let SAW run un-interrupted
Welding Cantilever SAW, robotic tracking ±1 mm joint Full penetration, low porosity, less rework
Flange Hydraulic straighten + PWHT runout < 2 mm/m Bolt-fatigue control — a documented collapse driver
Drilling CNC multi-axis flange ±0.5 mm hole Tower-to-tower bolt-up without field rework

That flange figure is not a marketing number – it is a safety chain. Heat-induced flange distortion drives bolt fatigue, which research links to in-service tower failures, so holding runout below 2 mm/m to DNV-grade limits is structural engineering, not finish.

// PARAMETERS

Engineering note — SAW parameters

automated cantilever SAW runs at 500-1200 A, 28-36 V and 30-60 cm/min with path-tracking robots, after 60°±5° bevels and a 2-4 mm root gap qualified to a written procedure under ISO 15614-1. Pre-heat sits at 80-150 C with 100-180 C interpass to stop cold cracking in high-strength thick steel, and a 600-650 C stress-relief anneal follows. Internal weld defects are then graded by ultrasonic testing to ISO 17640.

“We do not advertise a single headline number for deposition rate, because it changes with stand-off and plate thickness. What we hold to is the tolerance hand-off – if cutting drifts past 1.5 mm or fit-up past half a millimetre, the SAW head inherits the error. We tune the line so each stage protects the next.”

Aubrik Engineering Team, Wind Tower Line Integration
Honestly, even an automated line leaves residual manual scope, because internal fixtures and complex areas still require manual welding. What buyers experience as “low welding efficiency and difficult deformation control in fabrication of thick plates for offshore wind towers” is really upstream fit-up, not the arc — and the structural fix is that Aubrik engineers each station around the hand-off above, built around a measured tolerance budget. An EU buyer or regional fabricator inherits clean joints feeding the seam rather than a fast torch chasing a crooked one.

Sizing Your Line: Capacity & Cost-Per-Tower Economics

A first sizing mistake is confusing a tower-section line with a monopile foundation factory — a mismatch that risks oversizing, starving capacity, or burying the hidden cost of idle stations. Aubrik sizes a wind tower production line in tower sets per year and in steel tonnage, so you match the line to a real order book instead of a brochure throughput figure.

Sets-Per-Year Capacity Ladder

Output tier Configuration Steel throughput Best fit
60–120 sets/yr Single integrated line, 24 h ops, 2 sets / 3 days up to ~150,000 t/yr New entrant or regional supplier
180–300 sets/yr Line + duplicated welding & flange stations ~250,000–350,000 t/yr Established fabricator scaling onshore
up to 600 sets/yr Modular workstation expansion, no production stoppage up to 500,000 t/yr OEM-supplier / regional wind base

That ladder matters because you start at the bottom rung and bolt on modular workstations later without shutting the line down — the structural reason an industrial buyer scales capacity roughly 30% cheaper than a full rebuild. Aubrik engineers each tier around the same tubular steel tower geometry, built around your output target, so a regional producer building 100 a year and a 600-set OEM run identical proven stations at different counts.

Product specification range

Specification Range
Turbine capacity 2 MW – 8 MW
Tower height 60 m – 160 m
Tower diameter 2.5 m – 16 m (max 8.5 m for 15 MW-class sections)
Steel plate thickness 10 mm – 210 mm
Tower weight 50 t – 5,000 t per set
Material Q345, S355 low-alloy high-strength steel

That 8.5 m capability is on-trend, not over-built. The NREL/IEA Wind Task 37 15 MW reference turbine specifies a 10 m tower base, so 8.5 m sits in the working range for today’s largest onshore and offshore towers — and the frontier is diameter, not wall thickness, which is why a 210 mm plate ceiling leaves real headroom. The diameter trend is documented in NREL’s 15 MW offshore reference turbine definition.

Cost-Per-Tower Payback Model

Line economics turn on one number competitors never publish: arc-on duty cycle. Our model below uses industry benchmark ranges rather than a single invented figure, because honest payback depends on your plate mix and local labour rate.

+40%

productivity gain vs traditional fragmented lines on Aubrik installations

Corroborated independently: a comparable automated-line case reports +40% speed, −30% labour, <2-year payback (rchelec.com). Industry payback benchmark: 18–36 months.

Arc-On duty

Manual 8 – 30% VS automated SAW 80 – 95%. This is the main driver of throughput.

Deposition Efficiency

SAW ~99%; SMAW 60-65%. For 20MM weld depth, you need 2-3 passes SAW vs 5-7 passes smaw.

Labor Structure

One Xinjiang line reduced their tower-program of 6MW units from 80 staff to 25, cutting per- unit costs by 28% whilst increasing annual volume from 320 to 550 units per year.

[PROCESS_CORE]

Welding Equipment Inside This Line

Welding is the heart of the line, with two main equipment families carrying most of the work – it is only when the machines run as discrete units rather than an integrated, Aubrik-engineered cell that a fragmented shop hits an “alignment challenge”. These have individual product pages with detailed specifications if you’re purchasing at component level, but industrial users can even insert Aubrik stations into an established supply line. Operator and system-level demands align with ISO 14732 and every weld is verified at Aubrik’s FAT prior to dispatch.

[SPEC-01] ROTATORS & MANIPULATORS

ID: WTE-01

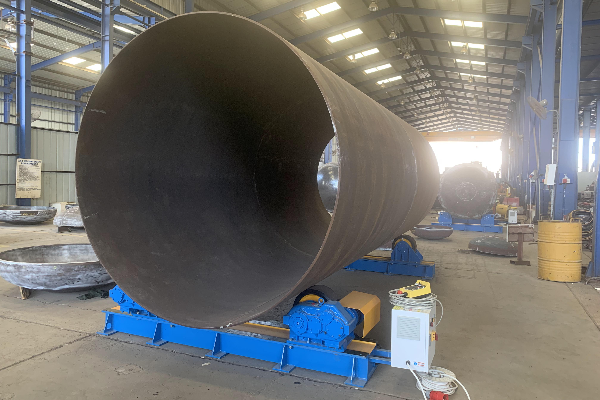

Wind Tower Welding Equipment

Wind Tower Welding Equipment

Column-and-boom manipulators, welding positioners, self-aligning welding rotators (weld rotators) and integrated welding lines for the longitudinal and circumferential seams of each turbine tower section. Explore the full range of wind tower welding equipment and model specifications.

[SPEC-02] CIRCUMFERENTIAL SEAM

ID: WTG-02

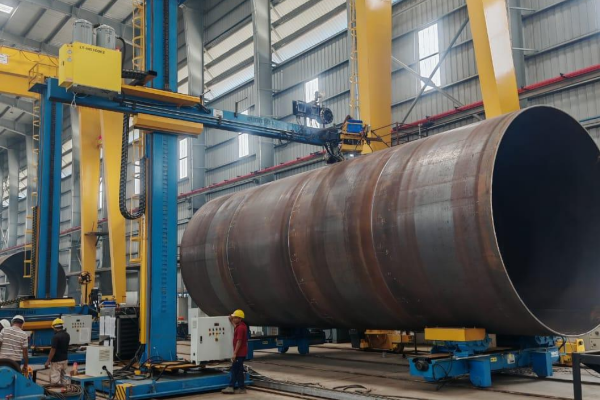

Wind Tower Girth Welder

Wind Tower Girth Welder

Dedicated circumferential-seam welders with laser seam tracking and flux recovery for ⌀3–8 m sections. See how automatic girth welding reaches a 99%+ NDT pass rate.

Aubrik Line vs Manual Fabrication vs Typical Imported Lines

This is not really a China-versus-Europe comparison — the heaviest wind-tower rolling is benchmarked to Italian builders, and Aubrik competes on published engineering rather than the lowest import price. What follows is the table the category avoids: specific numbers, graded against the weld-acceptance levels in ISO 5817, not Yes/No ticks.

Dimension Manual fabrication Typical imported line Aubrik integrated line
Welding accuracy operator-dependent rarely published ±1 mm joint, ±0.5 mm fit-up
Arc-on duty cycle 8–30% varies 80–95% (automated SAW)
Named weld/NDT standards shop-level logos only EN 1090-2 EXC3 · ISO 17640 · DNV-ST-0126
Annual capacity low, labour-bound static figure 60–600 sets/yr, modular
Named OEM clients unnamed “partners” Vestas, Siemens-Gamesa, GE, Goldwind
Support model in-house only agent / ticket relay 48 h on-site, turnkey commissioning
[SYS-01] COMPLIANCE ARCHITECTURE

Standards & Compliance, Mapped to Every Stage

Simply pointing to a Certification logo band gives you zero assurance about which standard controls which stage of your operations. Use our Standards-to-Stage compliance Map and see exactly how each of eight standards ensures your final quality at each of the six production phases.

[DATA-MATRIX] STAGE-TO-STANDARD MAPPING

Production stage
Governing standard
What it controls
Pretreatment
ISO 8501-1 (Sa 2.5)
Surface prep grade before coating
Forming / structure
EN 1090-2 (EXC3)
Execution class for fatigue-loaded steel
Welding (procedure)
ISO 15614-1 · AWS D1.1
WPS / PQR qualification
NDT — internal
ISO 17640 · NB/T 47013.3
Ultrasonic weld inspection
NDT — surface
ISO 17637
Visual inspection acceptance
Coating
ISO 12944 (C5 / CX)
Corrosion-protection durability
Whole structure
DNV-ST-0126 · CE
Support-structure design & certification

[SPEC-ANALYSIS-A]

Two factors distinguish a reliable map from a logo wall. wind towers are fatigue-loaded structures, so they fall under EN 1090-2 service category SC2 and are built to EXC3 – the documented wind-tower class in the ISO 12944 and EN execution framework – not the EXC4 some pages over-claim. And DNV-ST-0126 cover both onshore and offshore support structures, so its inclusion is not an offshore-only badge – it is the structural-design reference the rest of the line is built to satisfy. weld acceptance levels are graded against ISO 5817.

[SPEC-ANALYSIS-B]

For a procurement team, the risk is not a missing logo but a standard claimed and never mapped to a stage – the gap that fails an audit. Aubrik engineers the line so each gate is built around a named standard an EU buyer or regional fabricator can verify, and Aubrik certifies the line at FAT before shipment – the differentiator behind a 99%+ third-party NDT pass rate on delivered sections.

[SYS-02] CERTIFICATION STACK

EN 1090-2
EXC3 execution
ISO 17640
UT weld testing
ISO 12944
C5/CX coating
ISO 15614-1
WPS qualified
DNV-ST-0126
support structures
AWS D1.1
structural welding
ISO 8501-1
Sa 2.5 prep
CE · ISO 9001
QMS + EU market
[DATA-PROOF] CREDIBILITY METRICS

Proven on the World’s Wind Lines

Most rivals’ best social proof is three client names with no numbers – the credibility gap a new supplier has to close. Aubrik answers with named tier-1 OEMs and the production figures behind each relationship, the structural reason a risk-averse EU buyer or regional developer can shortlist an Aubrik factory it has not yet audited.

Case Study: Inner Mongolia 400 MW Programme (130 Sets)

Before Aubrik 8 sections / mo
Aubrik Integrated Line 32 sections / mo
88%
Prior Weld Qualification
99.2%
Aubrik Weld Qualification
*Moved to a 4 lift with 90% lower rework. That pattern repeats at section level.
SYS-01

Vestas

An 8-year partnership supplying three customised offshore production lines.

SYS-02

CS Wind America

A line supporting roughly 600 towers per year.

SYS-03

Dajin Offshore Heavy Industry

Large offshore tower and foundation output with a 40% efficiency increase and 25% cost reduction; Dajin’s own 2024 shipments exceeded 110,000 tonnes.

SYS-04

Siemens-Gamesa, GE, Goldwind

OEM-grade towers matched to each manufacturer’s design standards.

[TECH-SPEC]

That a tier-1 OEM such as Siemens Gamesa was still filing section-alignment patents in 2024 (EP4303430A1) shows how much fit-up accuracy still decides tower quality across the industry.

[DOC-REF: AUBRIK-PROCUREMENT]

Procurement Guide: Lead Time, Capacity Tiers & After-Sales

Buyers rarely leave a supplier over price – they leave over support, after sending three emails for one vague update. The structural reason is that an industrial buyer carries the project risk, so Aubrik structures procurement around the failure modes that wreck wind projects: opaque lead time, orphaned parts and broker-style overbooking for a regional fabricator far from the factory.

How an Aubrik line quotation is built

01

[SYS-01: CAPACITY]

Capacity tier configuration indicative lead-time band sizing drives the quote, not a flat catalogue number. Request a lead-time estimate against your target sets/yr.

02

[SYS-02: TESTING]

FAT before it ships factory acceptance testing on load, precision and weld performance, with a witnessed report, so the line is proven before transport.

03

[SYS-03: DEPLOYMENT]

Turnkey commissioning: project management, installation, commissioning and operator training with an on-site response within 48 hours via a global network.

04

[SYS-04: SUPPORT]

Warranty & spares: one-year warranty, with spare parts stocked in warehouses at several locations and software updates. OEM customisation for your specifications.

RISK ASSESSMENT: AGENT VS DIRECT

Compare to a purchased, imported line from an agent: 60-110 days from spec to site; field engineers replaced by relayed tickets because lower-tier suppliers rely on WhatsApp + time-zone-delayed support; a controller that requires on arrival rewiring when voltage, e.g. 480V / 60Hz, never had been confirmed.

It is the 6-stage, integrated line that constitutes self procurement – as there is no sub-contractors yard for your schedule to get “stuck”. Aubrik’s QM also follows ISO 9001, the QMS framework governing documentation and traceability throughout your construction process.

FAQ: Wind Tower Manufacturing Questions

What is a wind tower production line?

CNC cutting, shot blasting, plate rolling, fit-up, submerged-arc welding, flange machining, NDT and coating — together, those six Aubrik stations form one calibrated line that turns steel plate into a finished tower section.

What are the types of wind tower production lines?

Most commonly they are grouped by core function: cutting and preparation; plate rolling and forming; welding (both longitudinal and circumferential); flange and ring machining; and coating and finishing. These map to the fabrication requirements for wind towers set out in EN 1090-2 and DNV-ST-0126; Aubrik supplies the complete system, rather than components assembled from diverse sub-contractors with the resulting delays and handling inefficiencies.

What standards must a wind tower production line meet?

For European and most international tenders, the tower shell is fabricated to EN 1090-2 execution class EXC3 with CE marking, because wind towers are fatigue-loaded structures rather than static ones. Welds are qualified under ISO 15614-1, then inspected by ultrasonic testing to ISO 17640 and visual testing to ISO 17637. Surface preparation follows ISO 8501-1 Sa 2.5 and the coating system follows ISO 12944, while the complete support structure is designed and certified to DNV-ST-0126. Each standard maps to a specific production stage, so an auditor can trace any weld back to the procedure that governs it.

Can the line be integrated into existing equipment?

Yes. The line is built to allow addition of Aubrik welding, flange or NDT stations to existing facilities or integration of additional modules, potentially taking a single line up to 600 sets per year without production stoppages. We will ascertain voltage, footprints and interfaces during the RFQ process so there is no surprise rewiring on site.

Which tower specifications can it process?

Towers for 2-8 MW turbines, 60-160 m tall, 2.5-16 m in diameter (up to 8.5 m for 15 MW-class sections), in 10-210 mm Q345 or S355 plate, from 50 t to 5,000 t per set. Both onshore and offshore configurations are supported.

How long are installation and commissioning?

Lead time is quoted against your capacity tier, and the line is factory-acceptance tested before shipping. Installation, commissioning and training are turnkey, with 48-hour on-site response.

How is weld quality controlled?

Welding parameters (current, voltage, travel speed) are monitored and logged for traceability, then every weld is checked by ultrasonic testing for internal defects and visual inspection for surface defects, with dye-penetrant and radiographic testing on critical welds. Defects at or above φ2 mm are recorded, repaired and re-inspected.

How much does it cost to build a wind tower production line?

Price scales with capacity tier, automation level and certification scope, so a single integrated line and a 600-set/yr expansion sit far apart. We publish the cost factors openly and quote against your specification – contact Aubrik for a detailed quotation.
